632-3 Electrical Appurtenances
632-4 Power Service for Traffic Signals
632-5 Pole and Support Inspection - General
632-7 Sag and Vertical Clearance
632-8 Signal Span Messenger Wire and Appurtenances
632-9 Method of Measurement for Cable and Wire
632-10 Signal Equipment and Wiring
632-11 Signal Performance Tests and System Checks
This information is
intended to serve as a guide for construction personnel where the contractor
furnishes and installs traffic control devices and appurtenances. However, it
may also be useful for maintenance personnel performing the same functions.
Inspection procedures for the various type traffic control devices are
outlined, mainly in the form of check lists to assist project personnel in
performing their duties. This information points out the various important
features of each device and references the applicable specification or standard
drawing. Illustrations are used for easy recognition of the device or feature
being discussed.
See Section 630-3 for additional information
relative to concerns in the installation of foundations for poles and
controller cabinets.
This section will be
used to provide additional information about various electrical appurtenances
involved in the traffic signal installations, such as pull boxes, conduit and
ground rods.
Pull boxes shall be
of the specified sizes (see SCD HL-30.11
and the plans), typically 18 inches (460 millimeters) or 24 inches (610
millimeters), and the specified material.
The word on the cover
should be “TRAFFIC” when the pull box is part of a traffic signal system unless
the plans require the word “ELECTRIC” or other marking. The word shall be
formed on the surface or displayed on an attached metal plate in accordance
with CMS 725.09.
The location of pull
boxes shall be as shown on the plans. However, pull boxes in low drainage areas
may be adjusted to eliminate drainage problems, or feasible methods of positive
drainage may be used in accordance with CMS Item 603 and details on
SCD HL-30.11,
with the approval of the project engineer.
Pull boxes located
in sidewalks, traffic islands and curbed areas close to the roadway, where wide
turning vehicles could drive over them, may be adjusted to eliminate the
problem, or a concrete pull box with a heavy duty lid may be used with the
approval of the project engineer.
Trenching shall be
in accordance with CMS 625.11 and
as shown in TEM Figure 498-7.
Any change in dimensions will require approval by the project engineer.
Trenching may be in
earth or in paved areas, according to plan details. Trenching and subsequent
restoration of surfaces in paved areas shall be in accordance with SCD HL-30.22.
Trenching work in paved
areas shall be divided into two pavement depths for payment; less than 6 inches
(150 millimeters) and 6 inches (150 millimeters) or greater, as described in
CMS 625.21.
The trench in paved
areas may be 4 inches (100 millimeters) wide when cut by a Vermeer type
trencher. In this case, the trench shall be backfilled with concrete full
depth, except that the bottom 4 inches (100 millimeters) above the conduit may
be CMS 625.11
tamped backfill.
Metal conduit shall
comply with CMS 725.04,
with sizes according to the plans. It shall be made from domestically produced
steel, and the domestic steel content of the conduit shall be certified by the
manufacturer or supplier before it is approved for installation.
The routing of loop
detector wire in conduit through curb or under shoulder shall be as shown on
SCD TC-82.10.
Conduit containing
cable and/or wire shall have the terminal at the high end completely sealed in
an approved manner, with removable sealing compound or a molded plastic or
rubber device compatible with the conduit, cable jacket and wire insulation,
according to CMS 625.12(A).
After placement, a
conduit which will not have cable or wire pulled into it during construction
shall have a pull wire installed in it, and the terminal at the high end shall
be sealed with removable sealing compound, a molded plastic or a rubber device,
according to CMS 625.12(A).
Difficult pulling
and possible jacket skinning may occur when an attempt is made to install too
many cables or wires within a given conduit. The reason could be design error
in new systems or attempts to insert an excess number or size of cable or wire
in existing conduit.
Good electrical practice requires that the combined cross section of all cables and wire within a conduit should be less than (or equal to) 40 percent of the conduit inside area:
a1 + a2 + a3 + etc. < 0.40Ci
a = cable or wire across section area, sq. in. (mm2)
Ci = conduit inside area, sq. in. (mm2)
A calculation can be
made using the above formula. The cross section area of conduit, cable and wire
is shown in TEM Table 497-1.
A ground rod shall
be driven below groundline near the foundation of every strain pole and
overhead sign or signal support whether there is power in the vicinity or not,
as shown on SCDs TC-21.20,
TC-32.10
and TC-32.11.
Ground rods shall
comply with CMS 725.16
and be installed in accordance with CMS 625.09. A ground wire of insulated 600-volt No. 4
AWG 7-strand soft drawn copper shall be attached by an exothermic weld. The
typical exothermic weld procedure is described in Section 632-3.6.
Insulating varnish shall
be applied to the weld and any exposed conductor.
The following
procedure is typical and may be used unless the manufacturer’s instructions
differ.
Power service for
traffic signals shall comply with SCD TC-83.10
and the plans. It shall consist of the equipment needed to provide a
pole-attached wiring raceway and disconnect switch, for use with separately
furnished power cable routed from the service point to the controller cabinet.
As shown in TEM Figure 498-9,
unless otherwise specified, the equipment includes a weatherhead, a conduit
riser with necessary fittings and attachment clamps when required, and a
disconnect switch with enclosure (CMS 632.24).
A thorough review of
the plans should be made to determine that the specific requirements of the maintaining
agency for power service have been satisfied.
A ground wire shall
be used as shown on SCD TC-83.10,
leading to a ground rod installed in accordance with Section 632-3.5.
The LB type fitting
under the controller cabinet (SCD TC-83.10)
may have to be installed before erecting the pole because of interference with
the foundation.
When required, an
electric meter base shall be furnished by the applicable utility and installed
by the contractor as part of the power service work.
Power cable is the
only type cable or wire permitted through the power service conduit riser.
The conduit riser shall terminate at the meter base,
if used; otherwise, termination shall be at the switch enclosure. From there
conduit connection to the controller cabinet is as shown on the plans. Conduit
connection could be:
The conduit riser
shall comply with CMS 725.04
and the plans, and the weatherhead shall be threaded aluminum or galvanized
ferrous metal (CMS 732.16).
Risers on painted poles shall be painted to match the poles.
The disconnect
switch shall be a UL listed single-throw safety switch or circuit breaker,
meeting the voltage and capacity requirements of the specifications. The
amperage rating of the fuse or circuit breaker shall be 5 to 10 amperes greater
than the peak load rating of the equipment service. The enclosure shall be a UL
listed water tight lockable stainless steel NEMA Type 4, supplied with UL
listed conduit hubs, and the enclosure shall contain a solid neutral bar
normally grounded to the enclosure (CMS 732.21).
See Sections 630-4.2, 4.3
and 4.4 for information about pole
and support inspection.
This section will be
used to provide additional information about traffic signal supports. Various
types of overhead signal supports are also depicted in TEM Table 497-4.
Strain poles shall
comply with the manufacturer’s shop drawings, SCD TC-81.10
and the plans.
They shall be
galvanized unless paint is specified in the plans, and the general features
should be inspected in accordance with Section 630-4.2.
When strain poles of
the embedded type are specified, they shall include an extension for embedment
below groundline and a welded-on ground sleeve. The pole extension shall be
sufficient to reach within 3 inches (76 millimeters) of the foundation depth as
specified in the table in SCD TC-21.20,
or the extension may be a minimum of 6 feet (1.8 meters) if a reinforcement
cage is provided as also shown on the SCD. The cage shall overlap at least 24
inches (610 millimeters) of the pole extension and reach to within 3 to 4
inches (76 to 102 millimeters) of the foundation’s specified depth. A special
foundation design is required when soil with a load bearing capacity of less
than 2,000 pounds per square foot (9700 kilograms per square meter) is
encountered. Embedded poles normally do not include a handhole or blind half
couplings for internal wiring.
When shown on the
manufacturer’s shop drawings, and as permitted by CMS 732.11,
strain poles may be tapered tubes with a cross section which is circular or a regular
polygon of six or more sides, or may be a type consisting of straight sections
with a tapered effect accomplished by the use of reducers.
Strain poles used to
support traffic signals or signs (SCD TC-17.10)
shall be furnished with one or more span wire clamps with shackles for
attachment of messenger wire (see SCD TC-84.20).

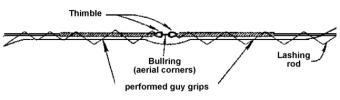

The messenger wire
may be attached by wrapping twice around the pole and securing with a
three-bolt clamp, as shown in SCD TC-84.20,
when used on round, tapered steel strain poles.
Erection of these
poles shall be in accordance with the general procedure given in Section 630- 4.6, except as noted in this
section.
For the initial rake
of strain poles of the anchor base type, leveling nuts shall be adjusted to
provide a rake of one-eighth to one-half inch per foot (11 to 42 millimeters
per meter) of pole in the direction opposite to the contemplated span wires and
are to be made snug tight. Further adjustment may be necessary to assure that
the strain poles are essentially vertical after the application of span wire
load.
For the initial rake
of strain poles of the embedded type, poles shall be embedded in concrete to
provide a rake of one-eighth to one-half inch per foot (11 to 42 millimeters
per meter) of pole in the direction opposite to the contemplated span wire and
braced. The age of the concrete before it is considered cured, before the
bracing may be removed, and before the permitted application of span wire load,
shall be in accordance with Section 630-3.4.
Single arm supports
shall comply with the manufacturer’s shop drawings, SCD TC-81.20
and the plans. General features of the support shall be inspected in accordance
with Section 630-4.2, and except as
noted in this section, erection of the support shall be in accordance with the
general procedure given in Section 630-4.6.
Welds shall be
inspected according to Section 630-4.3
and the galvanizing inspected according to Section 630-4.4.
For arms of two
telescoping pieces, a 15 inch (380 millimeters) overlap is required. The
overlapped arms shall be secured with a stainless or galvanized steel
through-bolt with hex head or nut(s). Arm caps shall cover at least 50 percent
of the end area (CMS 732.11).
An arm clamp with
clevis shall be furnished at each signal position, as well as a hole with a
rubber grommet for the outlet of signal cable.
The installation of
small signs and their attachment to the arms should be checked. Any possible
interference between swinging signals and signs should also be checked.
Blind half couplings
shall be located on the pole of the support for mounting pedestrian signal
heads or controller cabinets when required by the plans.
Signal heads shall
be installed so that their bottom surface is 16 to 18 feet (4.9 to 5.5 meters)
above the roadway. The signals shall be installed at essentially the same
elevation. Drop pipes should be used only when necessary to maintain the
clearance between 16 to 18 feet (4.9 to 5.5 meters). If the clearance without a
drop pipe will be slightly over 18 feet (5.5 meters), it is permissible to omit
the drop pipe, with the maintaining agency’s approval.
Initial rake shall
be adjusted so that under the load of signals, the pole will assume an essentially
vertical position and the arm rise be within the limits specified on SCD TC-81.20,
i.e., 3 inches (76 millimeters) minimum and 12 inches (300 millimeters)
maximum.
TEM Figure 498-13 illustrates sag guidelines and vertical
clearance standards for traffic signals.
This section will be
used to provide additional information about signal span messenger wire and
appurtenances.
Messenger wire and
accessories shall comply with SCD TC-84.20
and CMS 732.18.
Messenger wire diameter shall be in accordance with the plans.
The height at which
the messenger wire is to be attached to the pole will, in some instances, be
shown on the plans. In cases where this is not shown, the contractor is
responsible for determining the proper attachment height. This determination
shall consider the relative elevation of pavement to pole foundation top, the
desired clearance between pavement and the bottom of each signal, i.e., 16 to
18 feet (4.9 to 5.5 meters), the sag in the messenger wire (3 to 5 percent),
and the height of each signal.
Alternate methods of
attaching messenger wire to strain poles may be used, as follows:
If the messenger wire attachment to strain poles makes use of the alternative with pole clamps and anchor shackles, the wire is to be hooked through the shackle using a thimble and secured with a three-bolt clamp. A preformed guy grip shall not be used for messenger wire attachment at the pole. Guy grips of the proper size may be used at bull rings (aerial corners).
Thimbles with a correct
groove size for the messenger wire (or the wire and eye of guy grips) are to be
used at anchor shackles and bull rings. When three-bolt clamps are used, the
wire tail is to be served as shown in Section 632-8.3. See Section
632-8.4 for the installation procedure for preformed guy grips.
Thimbles with a
correct groove size for the messenger wire or the preformed guy grip shall be
used to connect to anchor-type shackles or to bull rings at span wire aerial
corners.
Messenger wire sag
shall comply with CMS 632.22
and Section 632-7.
The signal cable
shall be attached to the messenger wire by lengths of preformed lashing rod.
The lashing rod
shall be the proper internal diameter to snugly hold the cable, but not cut
into its jacket. See Section 632-8.6 for further information.
A drip loop shall be
formed in the signal cable at each weatherhead, and should extend at least 6
inches (150 millimeters) below the weatherhead (see TEM Figure 498-14).
Cables or groups of
cables up to a maximum of four, hanging within pole interiors, shall have their
strain relieved by cable support assemblies as described in Section 632-8.7,
TEM Figure 498-14 and
SCD TC-84.20.
Messenger wire may
be attached to various accessories by looping the wire to make an eye.
The wire end shall
be secured by a three-bolt clamp, and the cut wire end or tail shall be
“served” with construction wire or clamped with a sleeve device as shown on SCD
TC-84.20.
The following illustrations show both serving methods for the wire tail:
Preformed guy grips
are made of helically shaped high-strength steel wire. They are available in
sizes fitting the outside diameters of messenger wire and form an eye
permitting attachment to various accessories.
As shown in SCD TC-84.20,
they should be used at bull rings of span wire aerial corners (see the
following illustration). Thimbles are used in the eye of grips in accordance
with standard details in the SCD.
Grips are installed
on an end of the messenger wire by wrapping a first leg of the grip to the
messenger wire. In most cases, the accessory to which the grip is to be
attached must be inserted in the eye of the grip with a thimble before the
second leg of the grip is wrapped. The second leg is then applied to the
combined first leg and messenger wire. The following illustrations show the
wrapping sequence:
Guy grips shall not
be used on messenger wire used for span wire sign supports. In this
application, wind load on the signs can cause failure of the grips (see SCD TC-17.10).
Guy grips shall not be used for attachment to signal strain poles (SCD TC-84.20(5)).
In certain instances,
the plans will assign a color code usage for each cable, or a typical usage by
color code. All connections should be made observing these assignments, and any
deviations, if determined necessary, should be recorded. When a color code
usage is not provided, good electrical wiring practice would still dictate that
color code wiring on the project be consistent.
Typically, white is
reserved for the neutral or common leg of a circuit. The following provides
additional information about various types of cable and wire contained in CMS
Table 732.19-1:
As temperatures decrease, signal cable gets stiffer and harder,
becoming brittle when below freezing. In very cold weather, the cable should be
handled with care so as not to damage the jacket or insulation when unreeling,
flexing and installing. The method of measurement of signal cable is shown in TEM
Figure 498-16.
The cable may be either IMSA 19-1, IMSA 20-1 or IPCEA S-61-402 as in
signal cable, or twisted pair/shielded interconnect cable conforming to REA
PE-39 may be required by the plans.
Twisted pair/shielded cables are less prone to pick up induced current
as a result of nearby electrical devices or magnetic fields, and are necessary
for certain types of communication systems which may be used to interconnect
signals. The number of conductors and wire gage shall be as specified. It
should be noted that in the case of twisted pair/shielded cable, the number of
conductors is typically referred to as the number of pairs (pair count), i.e.,
sixconductor cable would be referred to as a three-pair cable. Conductors shall
be of copper and are usually solid.
Twisted pair/shielded interconnect cable of the integral messenger type
conforming to REA PE-38 may also be required by the plans.
The conductor shall be of copper and stranded. Loop detector wire
consists of detector wire inserted into a flexible plastic tubing (CMS 732.19)
meeting specifications IMSA 51-5. The tubing shall encase the wire completely
from the splice at the lead-in cable through the entire loop turns and back to
the splice.
Stranded copper may be substituted with an AWG one gage higher (wire
one size smaller).
When specified, power cable may be three conductor. Single conductor
cables may be substituted for a two (or three) conductor cable, but color
coding should still be provided.
A preformed helical
lashing rod shall be of the proper internal diameter to tightly secure overhead
cable(s) to the messenger wire. A lashing rod should not be loose or so tight
as to be impressed deeply or cut into the cable jacket. If either deficiency is
observed, the proper internal diameter may be determined by the following
formula: C approx. = (0.85) (D+m), where C is the lashing rod internal
diameter, D is the cable jacket diameter and m is the messenger wire gage (all
dimensions in inches (millimeters)).
For groups of
several cables of varying diameter, the internal diameter of the lashing rod
may be best determined by a graphic layout to scale.
Signal cable routed
on messenger wire should neatly pass the bull rings in its path. Also, signal
cable routed around an aerial corner formed in the span wire at a bull ring
should have a radius in its routing small enough to form a tangency with the
bull ring.
As shown in TEM
Figure 498-14, a
cable support assembly makes use of a flexible tubular wire mesh device called
a cable grip which has a gentle holding action over its length and which is
used to eliminate strain or damage to the jacket of cable(s) hanging in the
interior of poles.
The support assembly
consists of the grip attached to a single “U” eye support bale and a sling when
necessary. The grip may be used on an individual cable or a group of cables up
to a maximum of four (CMS 632.21).
The grip shall be the proper size and strength for the cable(s), of stainless
steel or tin coated bronze, and may be either a “closed” or “split with rod”
type. The split type is used when a cable end is not available. In this
application, the grip mesh is not a continuous tubular weave, but is split for wrapping
around the cable(s) and is secured by a rod which is inserted through alternate
weaves at each side to form a tube.
The support’s bale
shall be hung over the pole J-hook if sufficient length is available;
otherwise, a sling shall be made of messenger wire, clamps and thimbles. The
sling wire is to be passed through the bale eye, adjusted to the proper length
and hung on the J-hook.
Pole interiors
should be checked by removing pole caps to verify that cable support assemblies
are in place, hung on the J-hook and properly adjusted to eliminate cable
jacket strain.
For aerial
interconnect cable, the following standards and guidelines apply:
TEM Figures 498-16 through 498-20 illustrate the method of measurement for
signal cable, interconnect cable, detector lead-in cable, power cable and
service cable, respectively. CMS 632.29
also specifies the method of measurement for cable and wire.
This section will be
used to provide additional information about other signal equipment and wiring.
While the layout of
controller cabinets may vary, the following requirements and guidelines apply:
As noted in CMS 632.05,
cables and wires shall be identified as shown in TEM Table 497-2.
Illustrations of the
signal head visors, hangers and wiring discussed herein are presented in TEM
Figure 498-21.
Programmed heads (see
TEM Section 420-4.6) shall conform to approved catalog cuts, CMS 732.02
and 732.03,
and the plans. They are to have the correct number of optical sections making up
each face. Programmed heads have many points of similarity to regular heads.
Items 2, 3, 5, 11, 12, 13, 16 and 17 of Section 632-10.4 also apply to
these signal heads. For more detailed information, see publications by the
manufacturer.
Each optical section
shall be fitted with a visor (CMS 732.02
and 732.03)
and the interior surface of visors shall have a flat black finish.
Programmed heads
shall be mounted in a manner permitting little or no motion. If mounted on a
mast arm, a rigid adapter shall be used. Heads of more than three vertical
sections mounted on a mast arm shall be fitted with pipe backbracing, as shown
on SCD TC-85.20.
The pipe shall be a minimum of 17 inches (430 millimeters) behind the signal
center axis so that adequate clearance is provided for the programming
procedure. If heads are supported by span wire, a tether messenger wire shall
be attached to a fitting in the bottom of the signal’s lower section.
Customarily the
manufacturer’s representative will program the signals, but in accordance with
the plans, the contractor is responsible for the correct aiming and masking of
the signal so as to be visible to drivers or pedestrians only in the area
indicated on the plans.
Signals are
pre-tilted to cover most situations. The yellow indication section should be
aimed first and the other sections aimed similarly. The housing shall be opened
and the lamp collar and diffuser removed. The roadway inverted image should be
observed on the surface of the glass with the eye held a distance of 2 feet
(0.6 meter) behind. The image observed is where the optics are pointed. The
tilt of the integral adapter shall be adjusted so the horizon appears at the
lower third of the glass. The adapter screws are then to be tightened. All
sections shall be at the same tilt angle.
The signal shall be
rotated horizontally so the image on the glass covers the proper roadway
lane(s). The bolts of the mounting adapter shall be loosened and the signal
rotated around its serrated surface. The movement of traffic should be examined
on the glass. When the roadway image appears correct, that is, pointed in the
direction where it should be seen, all screws may be tightened. All sections of
the signal should now be adjusted and rigid in their mountings, properly aimed
and ready for masking.
The yellow
indication section of the signal should be masked first since it transmits a
brighter image. The other colors can then be masked identically.
Masking requires the
use of opaque tape furnished by the manufacturer. The tape shall be applied to
the glass, up to the edge, and squeegeed flat to remove air bubbles. The tape
initially should be applied horizontally to the glass to cover the image of the
sky and that portion of the roadway which is distant. After this is done, tape
should be applied to the images on the sides of the lane(s) where the signal is
not to be visible. In many cases, signal visibility is desired for a left turn
lane only, and visibility to the adjacent through lane should be masked. Excess
tape extending beyond the edge of the glass should be trimmed away, taking care
not to cut on the surface of the glass.
The reduced area on
the glass should be checked to verify that its image is the only area in the
roadway which should see the signal. The lamp collar and diffuser may now be
replaced and the housing latched.
The boundaries of
the area in the roadway where the signal is to be visible should be explored on
foot to verify that the head is properly programmed.
Pedestrian signal
heads shall conform to CMS 732.05,
approved catalog cuts, the plans and SCD TC-85.10.
Signals shall have the correct type of light source and lettering height in
accordance with the plans (CMS 632.08).
Housings shall have
a black finish, unless otherwise specified (CMS 732.05).
Visors shall be fitted over each message, except one type may have the entire
face protected by a flat black sunshade fastened close to the lens. The
interior surface of visors shall be flat black finish. Signals should be clean
and the assembly tight. Gaskets should be in good condition and lens door
hinges and latches in good working order.
Housings shall be
positioned with a minimum set back of 2 feet (0.6 meter) from the curb and a
height of 8 to 9 feet (2.4 to 2.7 meters) above the sidewalk for adequate
clearance. The heads shall be oriented toward their crosswalk and locked
securely in position.
Lamps for
incandescent signal heads of the 8-inch (200 millimeters) lens type shall be
1300 lumens (minimum initial), and for the 12-inch (300 millimeters) lens type
shall be 1650 lumens (minimum initial), unless otherwise specified.
Pedestrian push
buttons shall conform to Section 404-2, approved catalog cuts, and CMS 732.06.
Push button housings shall have a yellow finish, unless otherwise specified.
The push button shall be positioned 3.5 to 4 feet (1.1 to 1.2 meters) above the
sidewalk.
Push buttons on metal
poles shall be installed over a 3/4 inch (19 millimeters) maximum field drilled
hole with edge protected by two coats of zinc-rich paint and a rubber grommet
inserted.
The push button
housing curved back shall be positioned over the hole, wiring routed through to
the electrical mechanism and the housing secured by stainless steel screws.
Unused holes in the housing shall be plugged. Push buttons on wooden poles
shall have their wiring in conduit connected to a fitting of the signal
support.
Signal head supports
(conduit and fittings) on wooden poles shall be grounded, using a ground clamp
and an insulated ground wire stapled to the pole and covered by a molding.
OMUTCD Section 2L-3
addresses standards for the signs used where push buttons are provided to
actuate pedestrian signals. The sign legend shall conform to the plans.
TEM Figures 498-23 and 498-24 illustrate details related to the following
discussion of loop detector slots and wiring.
Unless otherwise
specified, loop detector lead-in cable (CMS Table 732.19-1)
shall be two conductor No. 14 AWG twisted pair shielded, with a jacket of black
polyethylene 0.04 inch (1 millimeters) thick minimum, and polyethylene
insulation with conductors of stranded copper.
Within the pull box,
loop wire ends shall be joined to the conductors of the lead-in cable by
soldering and covered with insulating material (see TEM Figure 498-25). An approved,
poured epoxy waterproof splice kit shall be used. It is understood that epoxy
splice kits are easily damaged by freezing temperatures encountered prior to
mixing. Damaged epoxy components may sometimes be recognized if either of the
components has turned or is streaked milky white.
Lead-in cable shall
be routed to the controller cabinet, fitted with soldered spade type terminals
and fastened to the correct points of the terminal block. The lead-in cable’s
shielding shall be grounded to the ground bus within the cabinet.
If a pull box is not
specified on the plans, the splice between the loop wire and lead-in cable
shall be made in the first entered pole or pedestal, except where the
controller cabinet is mounted on the pole or pedestal. If the controller
cabinet is mounted on the pole or pedestal, the loop wires may be routed
directly into the cabinet and no lead-in cable is necessary.
Loop detector
lead-in cable is measured in accordance with Section 632-9 and TEM
Figure 498-18.
The poured epoxy
splice in the pull box is included.
Magnetometer sensor
probes (TEM Figure 498-26)
may be set in the pavement, or under and in bridge decks in accordance with
SCD TC-82.10
at the locations shown on the plans.
Although core
drilling may be performed after concrete placement, it is preferred that probe
holes in new concrete be formed by pouring concrete around a vertical piece of
capped vinyl-chloride or other non-metallic tubing. Probe holes in existing
concrete must be core drilled. Probe installations under bridge decks may be as
shown in Figure 498-26. The lead from probes should be in non-metallic
conduit. Probes in bridge slabs should be centered in the reinforcing steel
grid square which is nearest to the probe’s plan location. The center of a grid
square may be located by the use of a Pachometer metal locator. The procedure for
use of such an instrument is given in Section 632-10.10.
Probe holes in
pavement and bridge decks shall be approximately 3/4 inch (19 millimeters)
greater than the probe diameter. The probe shall be set so as to have a covering
of at least 1 ˝ inches (38 millimeters). However, deeper placement may be used
if recommended in the manufacturer’s instructions.
The probe lead,
which is a part of the probe(s), is to be led from the probe(s) to the edge of
pavement, to the bridge parapet wall or under the bridge deck, depending on the
design used.
When in pavement and
bridge decks, the slot for the lead shall be a minimum of 3/8 inch (9.5
millimeters) in width and have a depth of 2 inches (50 millimeters) in concrete
and 4 inches (100 millimeters) in asphalt concrete.
Probe holes and
slots are to be brushed, blown clean of loose material and completely dry. The
probes are to be set and leads pushed to the bottom of slots with a blunt
wooden tool (or equivalent) to avoid damaging the insulation. Probe holes and
slots are to be completely filled with approved sealant and left undisturbed
until cured to a flexible state. The sealant should be the same as for loop
detector slots, as given in Section 632-10.7.
Probe leads in slots
at the pavement edge or curb shall be led into a 3/4 inch (19 millimeters)
conduit connecting to a roadside pull box. Care should be taken to prevent
excessive slack at the point where the lead enters the conduit. The high end of
the conduit is to be sealed in accordance with SCD TC-82.10.
Unless otherwise
specified, lead-in cable (CMS Table 732.19-1)
shall be four-conductor No. 18 AWG color coded, twisted, with a jacket of 0.026
inch (0.66 millimeters) minimum high density polyethylene and a low capacitance
insulation with conductors of stranded copper.
Within the pull box,
the probe lead ends shall be joined to the conductors of the lead-in cable by
soldering and covered with insulating material. An approved poured epoxy
waterproof splice kit shall be used. The kit should be the same as for loop
detector lead-in cable as given in Section 632-10.8.
Lead-in cable shall
be routed to the controller cabinet and fitted with soldered spade type
terminals and fastened to the correct points of the terminal block. The
shielding of lead-in cable shall be grounded to the ground bus within the
cabinet.
The installation of
magnetometer probes includes: the probe(s) and lead, the provision of probe
holes and pavement slots when used, sealant for the probe holes and slots, and
plastic conduit where required. Probes are measured as individual units with
the attached lead. Several probes may be on a single lead.
Magnetometer lead-in
cable is measured in accordance with Section 632-9 and TEM Figure 498-19. The poured
epoxy splice in the pull box is included.
A Pachometer is an
instrument used to detect the location of metal such as reinforcement bars
under a concrete cover. The instrument is a magnetic detector which operates on
the principle of the change in magnetic flux due to the presence of ferrous
metal.
A probe is connected to the instrument and is passed
over the concrete surface being examined. The instrument will indicate when the
pole of the probe is parallel to and directly over the axis of a reinforcing
bar. Use of the instrument will, therefore, outline the sides of a grid square
for accurate magnetometer probe location in the center.
Traffic control
signal components and the entire system shall be tested as required by various
specifications to assure proper operation before acceptance. Ground rods shall
be tested for satisfactory low resistance to ground. A circuit test should be
performed on all conductors to make sure there are no shorts, crosses and high
resistance or other improper connections. A cable insulation or megger test
shall be performed on all conductors to verify the integrity of the insulation
covering. All traffic control equipment in the controller cabinet should be
checked for correct settings and all controls manipulated for assurance of an
operable system.
Finally, the traffic
control system shall successfully pass a ten-day performance test, which will
give an opportunity for any hidden flaws to reveal their presence. As a final
“housekeeping” check, equipment should be observed for any evidence of
unattached ground wire, unlatched or unbolted doors, etc.
The results of the
various tests are to be entered by the contractor on test report forms (TEM
Form 496-6) as
required by CMS 632.28.
All ground rods
shall be tested by the contractor for earth resistance to ground, as required
by CMS 632.28(B).
Testing is to be in accordance with CMS 625.19,
except that the measurement need not be made immediately after installation.
Testing shall be performed before the ground wire is attached.
The quality of a
ground rod installation varies greatly depending on the characteristics of the
earth surrounding the rod. Clay or mud provides the best ground connection
since they are dense and contain sufficient moisture and metallic salts to make
them conductive. Sand or gravel bearing earth is less conductive.
One type of test
equipment commonly used consists of two probes connected to an instrument
consisting of a modified Wheatstone Bridge for balancing resistances. As shown
in TEM Figure 498- 27,
the probes are pushed into the earth to form, with the rod, a triangle of equal
10 foot (3 meters) sides.
The general range of
the rod’s resistance to ground is investigated by initially setting a
potentiometer knob to its highest range control knob, selecting the ohm range
(1000, 100, 10 or 1) which permits the balance meter pointer to be
approximately centered in its dial by adjustment of the potentiometer knob. For
this general range selection process, the pointer is activated by depressing
the test button to a reduced sensitivity position.
For actual testing,
the test button is fully depressed, thereby giving maximum sensitivity for
final adjustment of the balancing potentiometer. The pointer is carefully centered
in its dial by means of the potentiometer knob, and the rod resistance to
ground read in ohms by the position of the potentiometer knob. For example,
with the range knob set at 10 and the meter centered with a potentiometer knob
setting between 1.2 and 1.3, the rod resistance to ground is 12 ˝ ohms.
If the earth
resistance exceeds 10 ohms for signal controllers and tower lighting ground
rods, and 25 ohms for all other ground rods, the installation is unsatisfactory
and the contractor is required to proceed as follows (specified in CMS 625.09):
Before the
performance of any cable insulation (megger) test or the ten-day performance
test, a short-circuit test shall be performed by the contractor using a
volt-ohmmeter or other approved instrument (TEM Form 496-6 and CMS 632.28(C)).
Short-circuit tests shall be conducted with all electrical loads, power
sources, equipment grounds, and earth grounds disconnected (see TEM Figure 498–28).
Signal cable routed to signal heads may be tested with
connection made to the lamp sockets, but without the lamps being installed.
Each conductor shall
be measured against every other conductor and ground to assure that no
short-circuits, cross-circuits, or other improper connections exist. Continuity
should not exist between any conductor and any other conductor including
ground.
Each circuit branch
shall be disconnected and tested by the contractor for continuity by
temporarily jumpering each branch at its termination and measuring the
temporarily looped circuit for assurance that no open circuits exist (TEM
Form 496-6 and CMS 632.28(D)).
This testing is illustrated in TEM Figures 498-29 through 498-32. Each circuit
branch should be according to plan, with no high resistance connections and
with the proper identification.
Lead-in cable for
loop detector wire shall be tested before and after the cable is spliced to the
loop wire.
Circuit continuity
of signal cable may be done by applying 120 volts to each outgoing circuit and
observing that only the specific lamps are lighted.
This testing is
illustrated in TEM Figures 498-33 and 498-34.
Before energizing
the traffic signals the following functional checks should be made:
After energizing the traffic signals the following
functional checks should be made. In the event the signals are controlling
traffic at the time, these checks should be made with caution to protect the
safety of workers, pedestrians and drivers.
Some signal control
equipment, such as time clocks (or switches) and weekly programmers, are
intended to vary the timing patterns at different periods of the day or days of
the week. To determine if these required changes are occurring at the proper
times, it is necessary that observations be made to check the operation at
transition times over a period of several days.
The change in timing
shall not be extremely drawn out or abrupt. The accuracy of time clocks and
weekly programmers should be checked. Programmed changes should occur within
five minutes of scheduled times for clocks of the electromechanical type and
within one minute for clocks of the solid state type. No significant cumulative
clock error should be noted during the ten-day performance test.
After successful
completion of the ten-day performance test, and after a partial or final
acceptance of a project, the contractor is to turn over to the project engineer
all manuals, diagrams, instructions, guarantees and related material, as
required by CMS 632.05.
It is recommended that the project engineer list this material in the project
diary as a permanent record of the transfer. The project engineer should
transfer the material to the maintaining agency. For ODOT-maintained
signals the material should be given to the District Roadway Services Manager.
After a traffic
control system project has been accepted by ODOT,
the project engineer should immediately notify the maintaining agency that as
of a certain exact time and date, the agency is responsible for the operation
and maintenance of the system.
Before acceptance of
the traffic control system, the contractor shall furnish all personnel and
equipment required to successfully operate the system continuously for ten
consecutive days without major malfunction or failure (CMS 632.28(G)).
At least seven days
prior to the beginning of the performance test, the contractor shall notify the
project engineer of the starting date. The project engineer will notify the
maintaining agency (CMS 632.28(G)).
The contractor shall
arrange with the utility supplying the power for purchase of the energy
required to conduct the test. All costs of personnel, equipment, electrical
energy and incidentals required to perform the test are to have been included
in the contract unit prices for the respective items tested.
Minor failures such
as lamps, a single detector or an individual signal head, etc. shall be
immediately replaced or repaired and will not cause restart of the test.
A major malfunction or failure, such as a master or
local controller, interconnect equipment, etc. will cause termination of the
test, and after replacement or repair of the malfunctioning or failed
equipment, the beginning of a new ten-day test.
Items which have
been repaired or which are replacements are to be monitored by the contractor
for a period of ten days to provide assurance of their reliability.
The complete test
results are to be furnished to the project engineer on test reporting forms in
accordance with CMS 625.19.
The contractor is to record in the test results the beginning and end of the
test, and the method and date of the correction of each fault.
The project engineer
should record the following events in the project diary: the date of the
beginning of the ten-day performance test, a day-by-day record of faults as
they occur during the test, and the date of the successful completion of the
performance test.
After all wiring is
completed and all testing completed and accepted, a final inspection of the
traffic control system should be performed to assure a neat and workmanlike
appearance.
